Apptivo Implementation: 30/60/90 Rollout That Sticks

Plan a practical Apptivo rollout — owners, stages, adoption checkpoints, and what to defer so the CRM becomes the system of record.

By Lee M.Updated Aug 14, 20269 min readFact-checked

Quick answer

Roll out Apptivo in three phases: days 1–30 get selling work happening in the CRM, days 31–60 make Friday reviews run from Apptivo, and days 61–90 add only what still isn’t working. If sellers still need an admin for basic deal updates by week two, pause new features and fix that first.

  • Freeze 3 outcomes
  • Name an admin
  • Day 30: live pipeline
  • Day 60: light automation
  • Day 90: expand only if needed
  • Adoption before features

Apptivo rollout media

Official setup walkthroughs and product surfaces that matter while you roll out Apptivo — not a full product gallery.

Official Apptivo setup walkthrough

Vendor tutorial for onboarding and configuration. It is not a SoftwareGlimpse rollout plan — use this guide for judgment.

This video is hosted on YouTube

This content is hosted by YouTube. The player loads only after you allow marketing cookies.

Official vendor tutorial

Apptivo - Beginner's Guide to Apptivo CRM

What this shows

  • Apptivo CRM end-user navigation and core apps
  • Customer and activity collaboration basics

Product screenshots

Product screenshots coming soon

We only publish verified captures from Apptivo's product interface — never stock images, mockups, or teaching diagrams. Screenshots appear here once editorial review confirms them.

Full product screenshots and evidence live on the Apptivo research page.

Apptivo rollout takeaways

  • Implementation is habit work All-in-one business suite CRM with Lite, Premium, and Ultimate per-user plans plus Enterprise custom. None of that helps until the weekly loop is boring.
  • Sequence features to plan gates Our research does not flag plan-gated capabilities for Apptivo, but confirm your must-haves against the plan you actually intend to buy.
  • Enable in this order Days 1–30: contact management, lead management, pipeline management, and deal management. Days 31–60: reporting and workflow automation. Days 61–90: second pipeline and extra integrations.
  • Measure adoption, not configuration Count deals with a next step, stage moves per seller per week, and activities logged in Apptivo — not modules enabled.
  • Know what you inherited Research watch-outs to plan around: Less specialist sales CRM polish than Pipedrive-class tools; Ecosystem smaller than HubSpot/Salesforce; AI capabilities less documented.

Apptivo 30/60/90 path

  1. 1Outcomes + RACI
  2. 2Core loop
  3. 3Rhythm
  4. 4Expand
  5. 5Adopt or fix

Apptivo implementation walkthrough

Apptivo implementation walkthrough diagram.
Gate Apptivo rollout so configuration never outruns adoption.

Apptivo: must-have vs nice-to-have

Must-have
  • contact management and lead management
  • reporting
Nice-to-have
  • workflow automation
  • Forecasting
  • Sequences

Apptivo checklist

Bring these questions to every demo

Ask vendors to show the workflow live, not just describe it.

  • 1Freeze three 90-day outcomesBusiness language, not module names.
  • 2Assign RACI for admin + sales leadResponsible and Accountable names in writing.
  • 3Prove the day-30 core loopLive deals, training, Friday review inside the CRM.
  • 4Run four weeks of CRM-native reviewsTwo views + at most one automation.
  • 5Expand only unmet outcomesConfirm plan gates before new capabilities.
  • 6Run the adoption scorecardGreen / amber / red before calling it done.

1. Week 0: freeze three outcomes and assign RACI

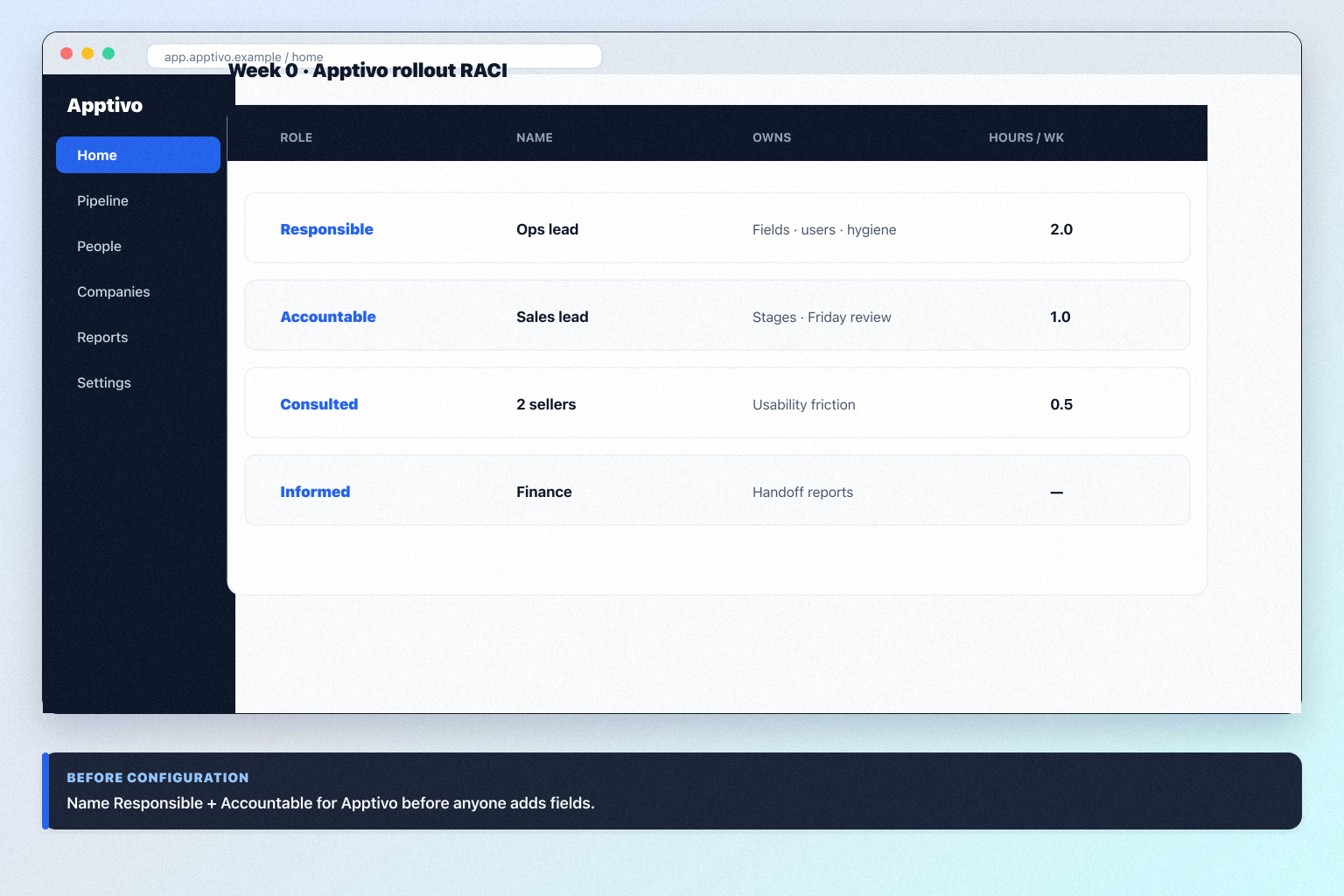

Apptivo implementation diagram 1.
Outcomes and owners come before configuration sprawl.

Lock three 90-day outcomes and name Responsible / Accountable before anyone configures Apptivo.

  1. Write exactly three 90-day outcomes in business language.
  2. Assign RACI — Responsible: Apptivo admin owner; Accountable: sales lead; Consulted: two sellers; Informed: finance and delivery.
  3. Write the “not now” list for anything not tied to the three outcomes.
  4. Book the day-30 and day-60 reviews in the calendar now.

Worked example: a 12-person B2B advisory team freezes three outcomes for Apptivo, gives ops two hours a week as Responsible, and defers extra pipelines and marketplace apps to day 61.

2. Days 1–30: make one loop real in Apptivo

Apptivo implementation diagram 2.
Days 1–30 in Apptivo: setup done → live deals → train the loop → Friday in CRM.
  • In scope

    contact management, lead management, and pipeline management and one pipeline.

  • Out of scope

    workflow automation — later phases.

  • Exit criteria

    Every open deal has an owner, a stage, and a dated next step.

  1. Finish the setup guide's six steps if they are not already done — pipeline, users, required fields, email sync, non-admin loop proof.
  2. Turn on only what the loop needs. Research supports contact management, lead management, pipeline management, deal management, and custom pipelines on your researched entry tier (Lite).
  3. Move real, current deals in — not a demo dataset. Sellers do not trust fake pipelines.
  4. Train on the loop, not the product: one 45-minute session where every seller creates a deal, logs an activity, and sets a next step in Apptivo on their own screen.
  5. Hold one Friday pipeline review inside Apptivo. If anyone reads from a spreadsheet, that is your day-30 defect.

Worked example: a 12-person B2B advisory team imports 40 live deals into Apptivo, runs one training session on their own pipeline, and bans the shadow spreadsheet from the Friday call in week three.

3. Days 31–60: build the weekly rhythm and light automation

Apptivo implementation diagram 3.
Days 31–60: two Apptivo views and at most one automation.
  • Healthy signal

    Deals move with notes; the forecast conversation uses CRM numbers.

  • Warning signal

    Empty next steps, or contact lists maintained outside Apptivo.

  • Hard stop

    No admin owner after 30 days — fix staffing before features.

Build the management rhythm in Apptivo before you automate.

  1. Build two views: open pipeline by stage with next steps, and deals with no activity in 14 days. Reporting is researched across every Apptivo plan we snapshot.
  2. Run every pipeline review from Apptivo for four consecutive weeks.
  3. Add automation only where a human forgets something predictable. Workflow automation is researched across every Apptivo plan we snapshot.
  4. Fix data quality with rules, not nagging.
  5. In Apptivo, open the reports, dashboards, or automation area — confirm the current control labels in the product, docs, or trial.

Worked example: a 12-person B2B advisory team adds two Apptivo views and one automation that creates a follow-up task when a deal enters proposal — then stops, because hygiene is still at 70%.

4. Days 61–90: expand only what evidence justifies

Apptivo days 61–90 expansion decision paths.
Expand Apptivo only when an outcome is unmet — not because a feature tour looks shiny.
  • Expand

    An outcome is unmet and the missing capability is the blocker.

  • Hold

    Outcome is met — resist the feature tour.

  • Escalate to plans

    The needed capability is gated. Our research does not flag plan-gated capabilities for Apptivo, but confirm your must-haves against the plan you actually intend to buy.

  1. Re-read the three outcomes. Expand only where an outcome is still missing.
  2. Then, in this order: second pipeline or extra objects, forecasting, sequences, enrichment, remaining integrations. Confirm which capabilities your Apptivo plan carries before scheduling this phase.
  3. Decide on AI deliberately. Our research does not list AI capabilities for Apptivo, so plan the rollout on process and habits rather than assistance features. Turn on one capability, measure whether reps keep using it after two weeks, then decide on the rest.
  4. Connect the remaining integrations from your requirements sheet. Our research does not name specific Apptivo integrations, so verify each connector you depend on in the vendor's integration directory before go-live.
  5. Write down what you chose not to do and why. That list is your renewal-time evidence.

Worked example: a 12-person B2B advisory team adds a second Apptivo pipeline for renewals, enables one AI capability for meeting summaries, and leaves enrichment off because nobody could name the decision it would change.

5. Run the adoption review before anyone says “done”

Apptivo implementation diagram 4.
Green / amber / red adoption gates for Apptivo before you call rollout done.

Score five adoption metrics at day 30, 60, and 90 before you add more Apptivo features.

  1. Percentage of open deals with a dated next step.
  2. Stage moves per seller per week.
  3. Activities logged per seller per week.
  4. Number of shadow spreadsheets still in use.
  5. Admin hours actually spent versus the two hours committed.

If three of five are weak, do not add Apptivo features — simplify stages, retrain, or fix ownership.

Worked example: at day 30, two of a 12-person B2B advisory team's sellers still rebuilt Friday in a spreadsheet. The team paused automation, cut two Apptivo stages, retrained in 30 minutes, and hit 90% next-step coverage by day 45.

Apptivo implementation mistakes

  • Configuring everything in week one

    Unused modules create noise and maintenance. Ship contact management, lead management, pipeline management, and deal management first in Apptivo.

  • No named admin owner

    Without Responsible and Accountable names, fields and hygiene rot quietly.

  • Training managers instead of sellers

    A manager demo is not a non-admin walkthrough on a seller's own screen.

  • Automating a broken process

    Workflow automation in Apptivo multiplies whatever process you already have — including the mess.

  • Enabling gated features you did not buy

    Our research does not flag plan-gated capabilities for Apptivo, but confirm your must-haves against the plan you actually intend to buy. Confirm the plan before you put a capability in the rollout plan.

  • Ignoring a documented tradeoff

    Research flags: Ecosystem smaller than HubSpot/Salesforce. Decide how you will live with it before day 60.

Frequently asked questions

  • How long does Apptivo implementation take?

    Small teams reach a usable core loop in weeks when outcomes are frozen and an admin is named; the 30/60/90 frame exists for habits, not clicking. Decision rule: do not call it done until non-admins run the loop unaided and a new hire can follow the one-page note.

  • What should we enable first in Apptivo?

    Start with contact management, lead management, pipeline management, and deal management on your entry tier (Lite), one pipeline, and required fields. Everything else waits for adoption evidence.

  • When should we turn on automation?

    Days 31–60, after four clean weekly reviews. Workflow automation is researched across every Apptivo plan we snapshot. Automate only predictable human forgetfulness — task creation, owner assignment.

  • When should we enable AI in Apptivo?

    Our research does not list AI capabilities for Apptivo, so plan the rollout on process and habits rather than assistance features. Enable it in the days 61–90 phase, one capability at a time, and keep it only if reps still use it two weeks later.

  • What adoption metrics actually matter?

    Next-step coverage on open deals, stage moves per seller per week, activities logged per seller, surviving shadow spreadsheets, and real admin hours. Modules enabled is a vanity metric.

  • Do we need consultants?

    Many SMB Apptivo rollouts succeed with an internal admin and a one-page plan. Bring help when integrations, complex permissions, or a large migration exceed that capacity — and scope it in writing against your three outcomes.

  • What if adoption stalls at day 60?

    Stop adding features. Cut stages, re-train on the loop, and check whether the admin owner actually has time. If the core loop still fails, re-open the fit question in the Apptivo worth-it guide and compare Zoho CRM and Bitrix24.

  • What should I do next?

    Use the Apptivo setup guide for day-zero configuration, the migration guide if history is still moving, and the plans guide if a needed capability turns out to be gated.
